← All articles

· 1 min read

How Much NMR Is Locked During Atomic Migration?

Updated

Adding every unresolved round’s principal did not measure legacy locked NMR. One legacy balance could support several overlapping rounds, so summing those exposures counted the same capital repeatedly. Atomic positions change that accounting unit.

Revised September 8, 2026. The earlier unresolved-round sum and locked-capital multiple are withdrawn as measures of TVL.

Use balances for capital and positions for exposure

Reconciled current staked NMR by tournament and legacy versus atomic generation on September 8, 2026
Enlarge chart

The source reported about 653,000 NMR for Classic, 201,000 for Signals and 53,800 for Crypto. These are current staked balances from the generation breakdown. An idle strategy balance or a claimable position is a separate state; the breakdown should not be relabeled as all participant assets.

Classic round principal fell sharply at round 1343. Multiplying its approximately 12,528 NMR by 64 gives an allocation illustration of about 802,000 NMR. That is not a measurement of simultaneous locked capital during a gradual migration.

A schedule does not free capital

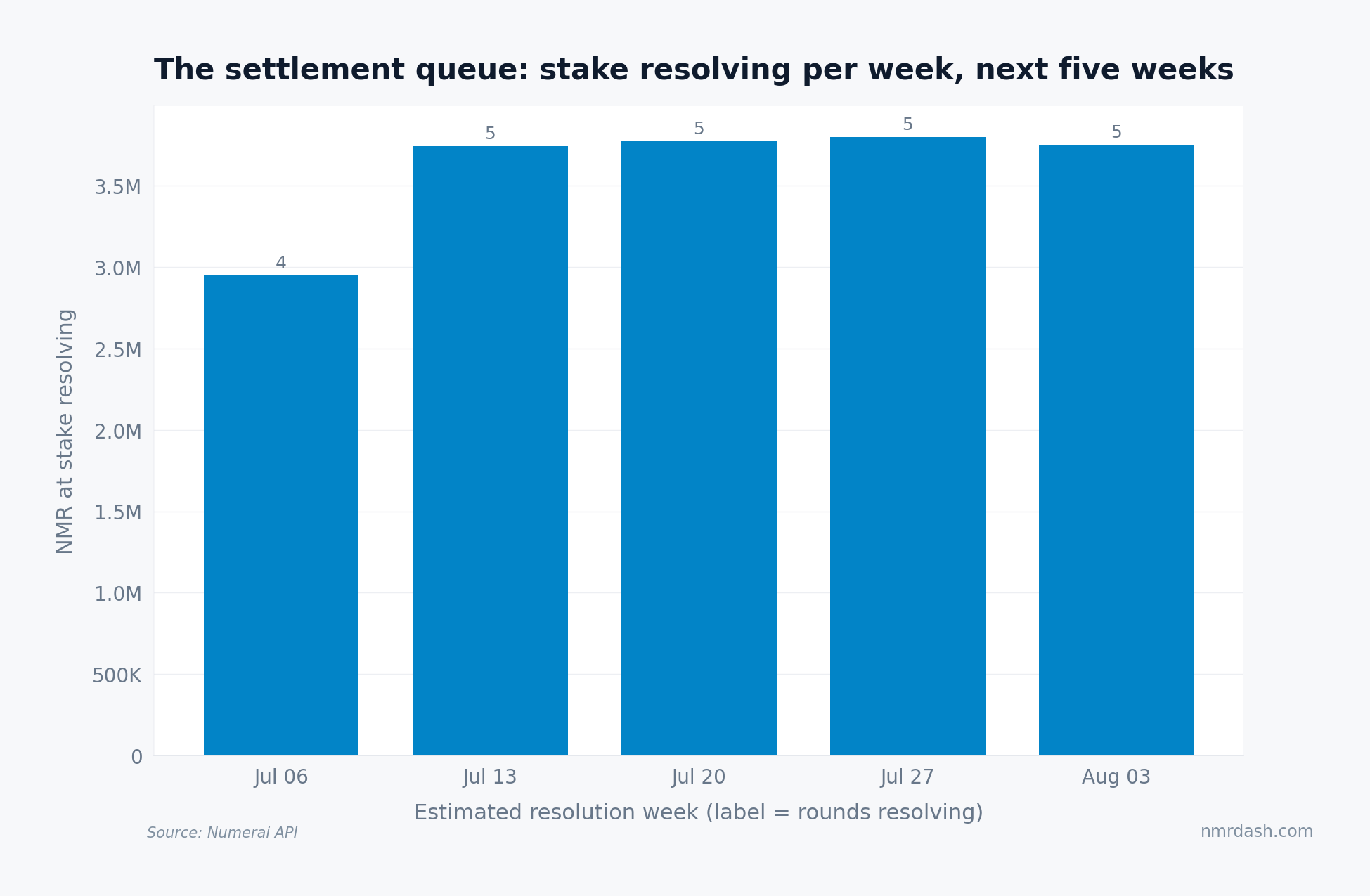

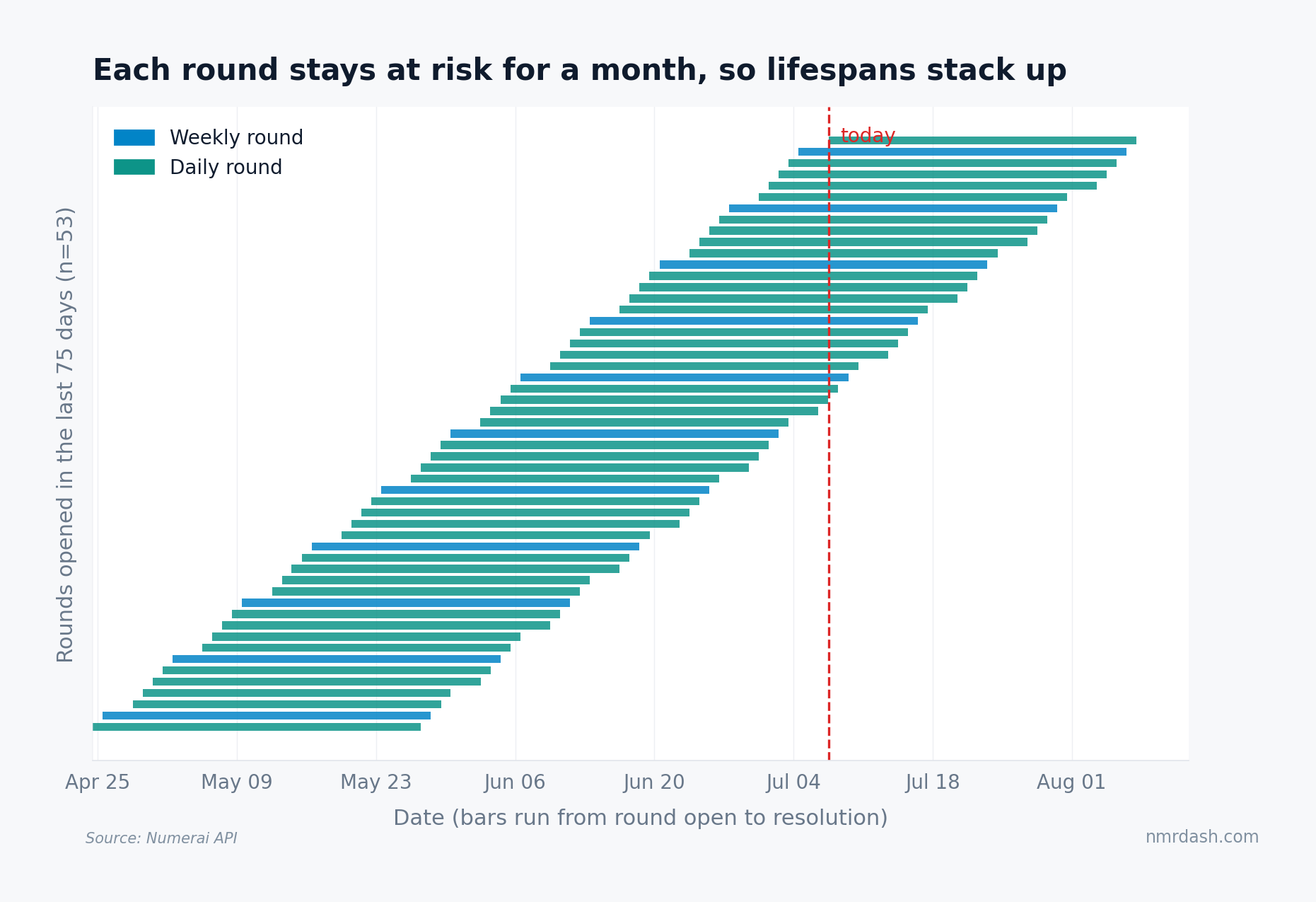

An expected round end tells an account when release may become possible. It does not prove a claim was processed. Actual capital availability depends on the position state and subsequent claim or restaking event. The round calendar distinguishes those clocks.

The dashboard’s stake history reports Numerai’s overview histories with their source dates; it is not a reconciliation of concurrently locked legacy and atomic capital. I would reject any capital series that splices raw legacy and atomic principal without identifying the boundary.

Method: nmr-info balances at September 8, 2026, 11:18:56 UTC; all three tournaments, with Erasure excluded. No unresolved-round summation or overlap multiplier is used in the balance figure. See atomic mechanics.

This research retains its original data window. Current dashboard observations have their own source dates. Report a correction.
Open full size
